Introduction
Most enterprise hybrid cloud environments were never architected — they grew by default. One workload moved to AWS for scalability. A compliance requirement pushed another system to a private cloud. Legacy applications stayed on-premises because migrating them felt too risky to justify.
Over time, IT teams ended up managing two or three environments that were never designed to operate together.
This gap between how hybrid cloud gets built and how it should be built is what makes migration decisions expensive when mishandled. According to Flexera's 2026 State of the Cloud report, estimated wasted IaaS/PaaS spend has reached 29% of total cloud budgets — a direct consequence of environments that outpaced the governance structures meant to manage them.
This guide covers both sides of that decision: how to build a hybrid cloud migration strategy that holds up under real workload complexity — including workload assessment, phasing, and governance — and how to evaluate migration partners before committing to an engagement.
TL;DR
- Hybrid cloud migration distributes workloads across on-premises, private cloud, and public cloud based on deliberate placement decisions
- The 7 Rs framework (Rehosting through Reimagining) is the standard taxonomy for workload-level migration decisions
- Successful migrations follow a phased sequence: workload audit → architecture design → phased execution → monitoring
- Partner selection should prioritize end-to-end lifecycle capability, compliance credentials, and post-migration managed services
- Deciding what stays on-premises matters as much as deciding what moves
What Is Hybrid Cloud Migration?
Hybrid cloud migration is the process of moving an organization's applications, data, and workloads across a combination of on-premises infrastructure, private cloud, and public cloud environments — while deliberately determining where each workload lives based on performance, security, compliance, or cost requirements.
The distinction from full cloud migration matters. In a hybrid model, some systems remain on-premises by design, not by default. Organizations retain control over sensitive or regulated data while using public cloud for customer-facing or elastically scaled workloads.
NIST defines hybrid cloud as a composition of two or more distinct cloud infrastructures — private, community, or public — bound together by standardised or proprietary technology enabling data and application portability.
Core Components of Hybrid Cloud Architecture
A hybrid cloud environment operates across three layers:
- On-premises infrastructure — owned data centers running legacy or latency-sensitive workloads
- Private cloud — dedicated cloud environment for a single organization, offering greater control than public alternatives
- Public cloud — third-party providers (AWS, Azure, GCP) delivering elastic compute, storage, and managed services
Orchestration and management tooling unifies these layers into a single operational environment. Modern hybrid deployments increasingly extend to hybrid multicloud — using services from multiple public vendors simultaneously to avoid lock-in and access the strongest capabilities per use case.
Kubernetes plays a central role in enabling that portability. Google Kubernetes Engine, for example, runs on open standards that let workloads move unmodified across providers — a meaningful safeguard against vendor dependency.
The 7 Cloud Migration Strategies
Choosing where each workload lives — and how it gets there — depends on the migration strategy applied to it. The 7 Rs framework, originally built on Gartner's 2011 work and expanded by AWS, is the standard taxonomy for categorizing those approaches:

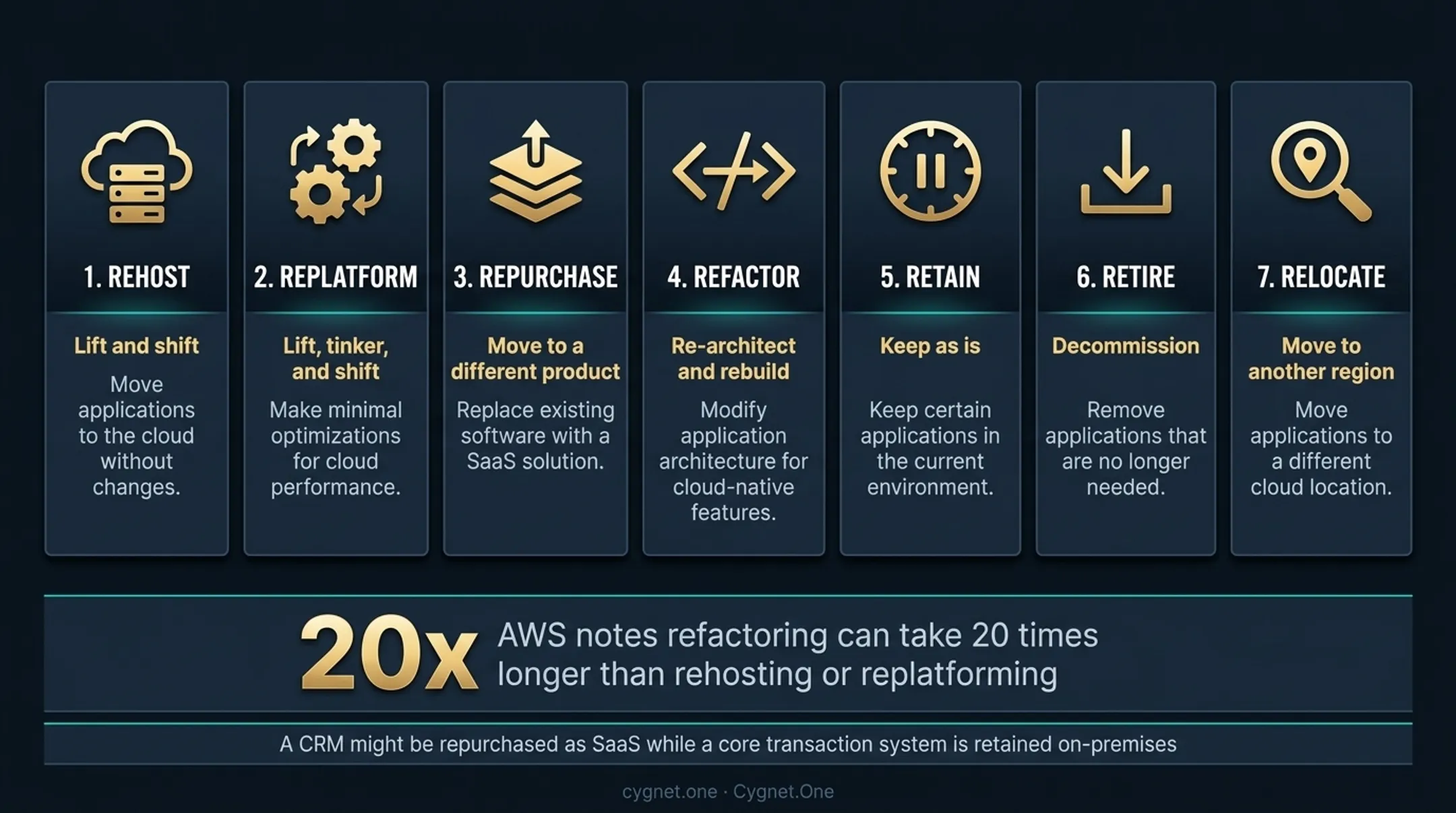

| Strategy | What It Means |
|---|---|
| Rehosting | Lift-and-shift — migrate as-is with no changes |
| Replatforming | Minor adjustments to optimise for cloud without rearchitecting |
| Repurchasing | Replace with a cloud-native SaaS alternative |
| Refactoring | Re-architect for cloud-native features like microservices |
| Retiring | Decommission obsolete systems |
| Retaining | Keep on-premises due to regulatory or performance constraints |
| Reimagining | Transform business processes around cloud-native capabilities |

A critical point: AWS notes that refactoring can take 20 times longer than rehosting or replatforming because code and architecture change simultaneously. For large migrations, rehosting and replatforming are typically preferred for velocity — optimisation and modernisation come in later waves.
In hybrid migrations, organizations apply multiple strategies simultaneously across different workloads. A CRM might be repurchased as SaaS while a core transaction system is retained on-premises — the architecture from the previous section dictates which strategy fits each layer.
Building Your Hybrid Cloud Migration Strategy
A hybrid cloud migration without a structured strategy is one of the most reliable ways to overshoot timelines. The steps below should happen in sequence — skipping the audit or architecture phases to begin migration faster creates problems that cost more to fix than the time saved.
Step 1: Conduct a Workload Audit and Dependency Mapping
The workload audit is the non-negotiable starting point. Document every application, database, and service currently running on-premises, capturing:
- Compute and storage consumption
- Application dependencies and integration points
- Business continuity impact if the system is unavailable
- Licensing constraints that affect cloud deployment
Use the output to place each workload into one of three buckets:
- Cloud-ready — can migrate with minimal changes
- Needs refactoring — requires rearchitecting before cloud deployment is viable
- Intentionally on-premises — stays by design, not inertia
Latency-sensitive systems, data residency-constrained workloads, and legacy applications with rigid licensing typically belong in the third bucket. Cygnet.One's ORBIT framework begins with exactly this kind of structured estate audit — mapping applications, infrastructure, dependencies, and data flows before any workload moves.
Flexera's 2026 report found 52% of organizations struggle to understand application dependencies and 48% struggle to assess technical feasibility during migration — the strongest argument for investing properly in this phase.
Step 2: Design Architecture and Network Connectivity Before Migration Begins
Three elements must be resolved at the blueprint stage:
- Network connectivity: Use private connections (AWS Direct Connect, Azure ExpressRoute, Google Cloud Interconnect) rather than public internet routing. This delivers consistent throughput and a reduced attack surface. Each major cloud provider has a dedicated interconnect product; align your choice with your primary platform.
- Identity and access management: Federated identity, single sign-on, and role-based access policies must be consistent across both on-premises and cloud environments from day one. Retrofitting IAM after migration is far more complex.
- Data residency: Define where each data category lives and what controls govern cross-environment transfers. For organizations operating across multiple regulatory jurisdictions, this means mapping each workload against applicable regulations before architecture is finalized.
Enterprises with complex ERP systems — SAP, Oracle, Microsoft Dynamics — face additional integration design requirements at this stage. Financial and operations data pipelines must remain live throughout migration, which means API management, data synchronization, and integration architecture need to be scoped before migration execution begins.
Step 3: Choose Platforms, Execute in Phases, and Establish Monitoring
Platform selection: Evaluate hybrid platforms (AWS Outposts, Azure Arc, Google Anthos) against your existing technology stack and operational familiarity — not vendor benchmarks. Run a proof-of-concept with real workloads before committing.

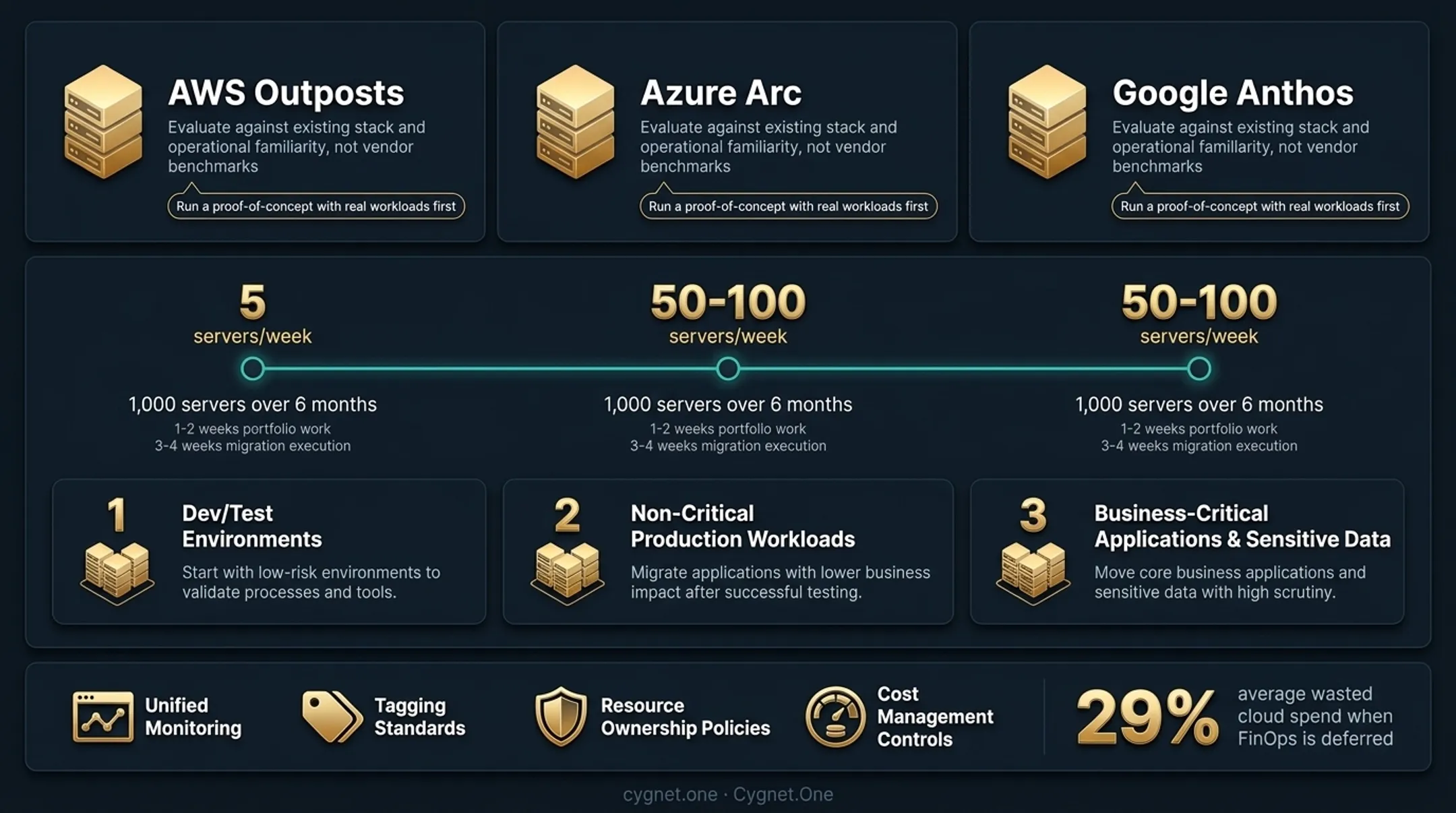

Migration sequencing: AWS prescriptive guidance recommends a wave-based approach. A large migration — 1,000 servers over 6 months — starts at 5 servers per week and scales to 50-100 per week as the team builds confidence. Each wave typically includes 1-2 weeks of portfolio work and 3-4 weeks of migration execution.
A practical three-phase structure:
- Dev/test environments — lowest risk, surfaces integration gaps early
- Non-critical production workloads — validates monitoring and rollback processes
- Business-critical applications and sensitive data — by this point, the team has worked through the learning curve

Post-migration governance from day one: Establish unified monitoring across on-premises and cloud tiers, tagging standards, resource ownership policies, and cost management controls before the first workload moves. With wasted cloud spend averaging 29% of total budgets, FinOps governance belongs in the migration plan — not deferred to a post-migration backlog.
Key Factors for Selecting the Right Hybrid Cloud Migration Partner
Partner selection is where many organizations underinvest attention — often defaulting to brand recognition or price instead of evaluating actual fit. The factors below connect a partner's capabilities to the specific operational, compliance, and technical requirements of a hybrid migration.
Factor 1: End-to-End Migration Capability Across the Full Lifecycle
A partner covering only migration execution — not workload assessment, architecture design, or post-migration managed services — forces organizations to coordinate handoffs between multiple vendors. Each handoff creates gaps in accountability and compresses timelines in ways that are difficult to recover from.
Gartner's 2024 Critical Capabilities report evaluates cloud transformation partners across the full lifecycle: baseline capabilities, professional services, managed services, agile migration, modernisation, monitoring and optimisation, and knowledge transfer. Coverage across all of these areas reduces coordination overhead and improves timeline predictability.
Factor 2: Security Credentials and Compliance Framework Coverage
Hybrid environments carry a broader attack surface than single-environment setups ; every integration point between on-premises and cloud is a potential vulnerability.
Evaluate whether the partner holds:
- SOC 2 Type II, ISO 27001, CMMI certifications
- Demonstrated zero-trust architecture implementation capability
- Centralised SIEM and threat detection across both environments
- Compliance framework experience relevant to your industry (GDPR, HIPAA, PCI-DSS, or regional standards)
KPMG's 2023 Cloud Transformation Survey found 87% of organizations had auditors or regulators identify at least two cloud-related audit issues , and 43% had six to ten issues. Security and compliance are migration workstreams, not post-migration cleanup items.
Factor 3: ERP and Enterprise Integration Depth
For BFSI, FMCG, and IT Services organizations, hybrid migrations rarely exist in isolation. They interact with ERP systems, financial platforms, and data pipelines that must continue operating throughout the migration.
Assess the partner's track record with:
- SAP, Oracle, Microsoft Dynamics integration
- API management across hybrid environments
- Data synchronisation without production downtime
Cygnet.One's 250+ successful ERP integrations across SAP, Oracle, Microsoft Dynamics, and Tally reflect the depth of experience complex enterprise migrations require. Their SAP practice uses automated testing via TestingWhiz to validate that financial and operational systems remain functional throughout migration, and their Cygnet Cosmos framework addresses business process continuity for SAP environments.
Factor 4: Proven Phased Methodology and Rollback Capability
Running a migration as one large-scale project, without defined phases or rollback gates, is one of the most consistent predictors of budget overruns. Evaluate whether the partner can demonstrate:
- A structured phase approach with defined wave cadences
- Tested rollback procedures at each phase gate
- Parallel-run testing before final cutover
- Measurable SLAs for each migration wave
Cygnet.One's ORBIT framework (Observe, Roadmap, Build, Iterate, Transform) embeds rollback procedures and automated testing gates at every stage. Blue-green and canary deployment patterns eliminate downtime risk for production systems during cutover.

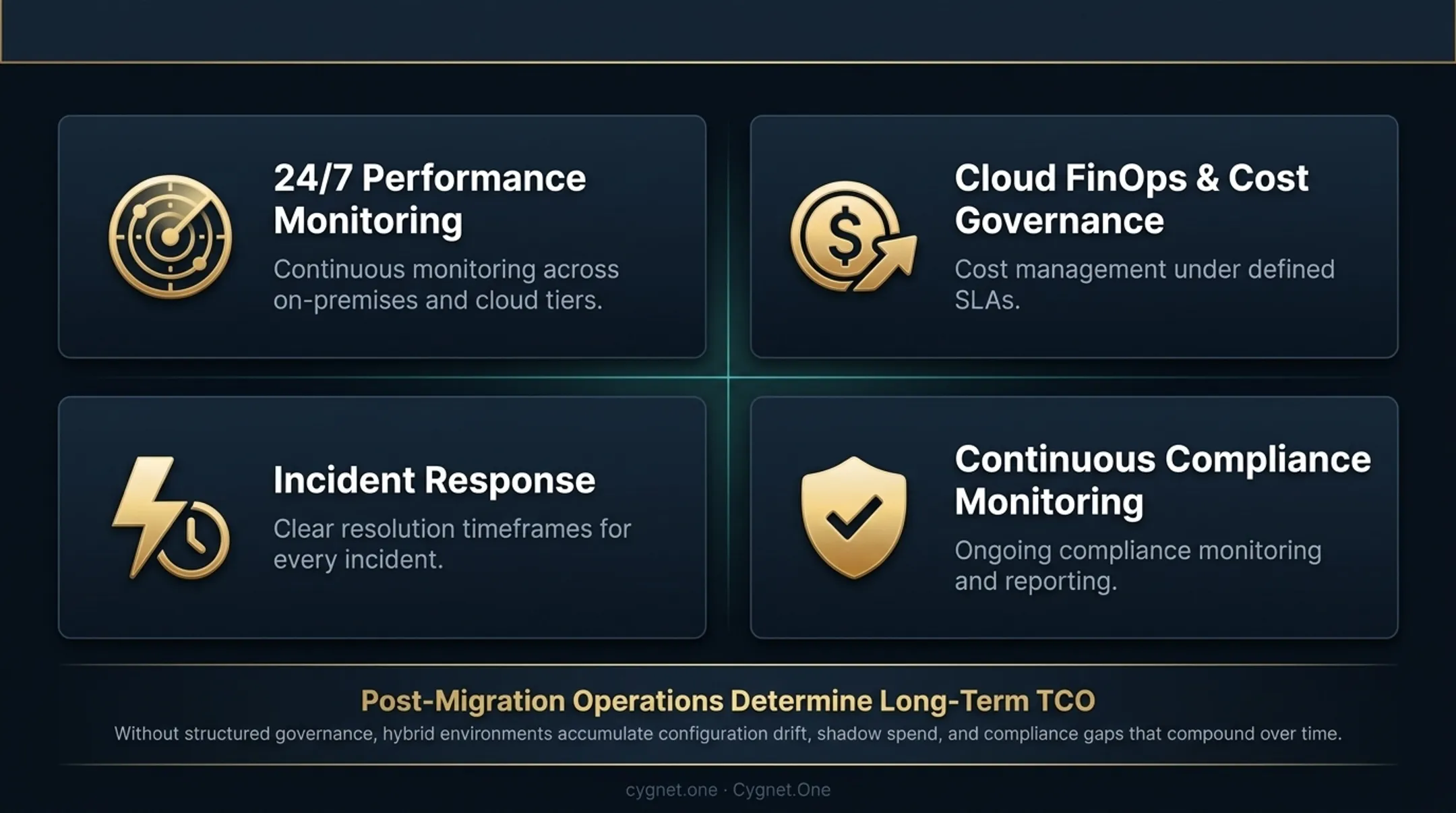

Factor 5: Post-Migration Managed Services and Governance Support
The migration event is not the end of the engagement. Hybrid environments require ongoing monitoring, cost governance, security operations, and optimisation. Evaluate whether the partner offers:
- 24/7 performance monitoring across on-premises and cloud tiers
- Cloud FinOps and cost management under defined SLAs
- Incident response with clear resolution timeframes
- Continuous compliance monitoring and reporting
Post-migration operations determine long-term total cost of ownership. Without structured governance, hybrid environments accumulate configuration drift, shadow spend, and compliance gaps that compound over time — costs that dwarf the original migration budget.

Common Challenges in Hybrid Cloud Migration
Three failure points consistently derail hybrid migrations.
Integration Complexity
Incompatible technology stacks between legacy on-premises systems and new cloud infrastructure demand tooling and architecture decisions made before migration begins — not discovered mid-execution. More than half of organizations report struggling with application dependency mapping, which is why a thorough audit phase is non-negotiable.
Data Governance and Residency Gaps
As data spreads across multiple storage environments, maintaining integrity, availability, and regulatory compliance becomes considerably harder to manage. In regulated industries, this isn't a technical inconvenience — it's a compliance exposure. KPMG research found enterprises averaged 8 data loss incidents per year, frequently tied to governance failures during or after cloud transitions.
Uncontrolled Cloud Cost Growth
The public cloud billing model differs fundamentally from on-premises CapEx. Without governance policies locked in before migration, spend escalates faster than projected. Organizations that skip FinOps setup during planning tend to discover the consequences at the end of their first quarter in production.
Each challenge is manageable in isolation. When they converge — as they routinely do in unstructured migrations — they erode ROI before the project ever reaches steady state. Identifying these risks during the planning phase, not after go-live, is the difference that structured partner engagement makes.
How Cygnet.One Supports Your Hybrid Cloud Journey

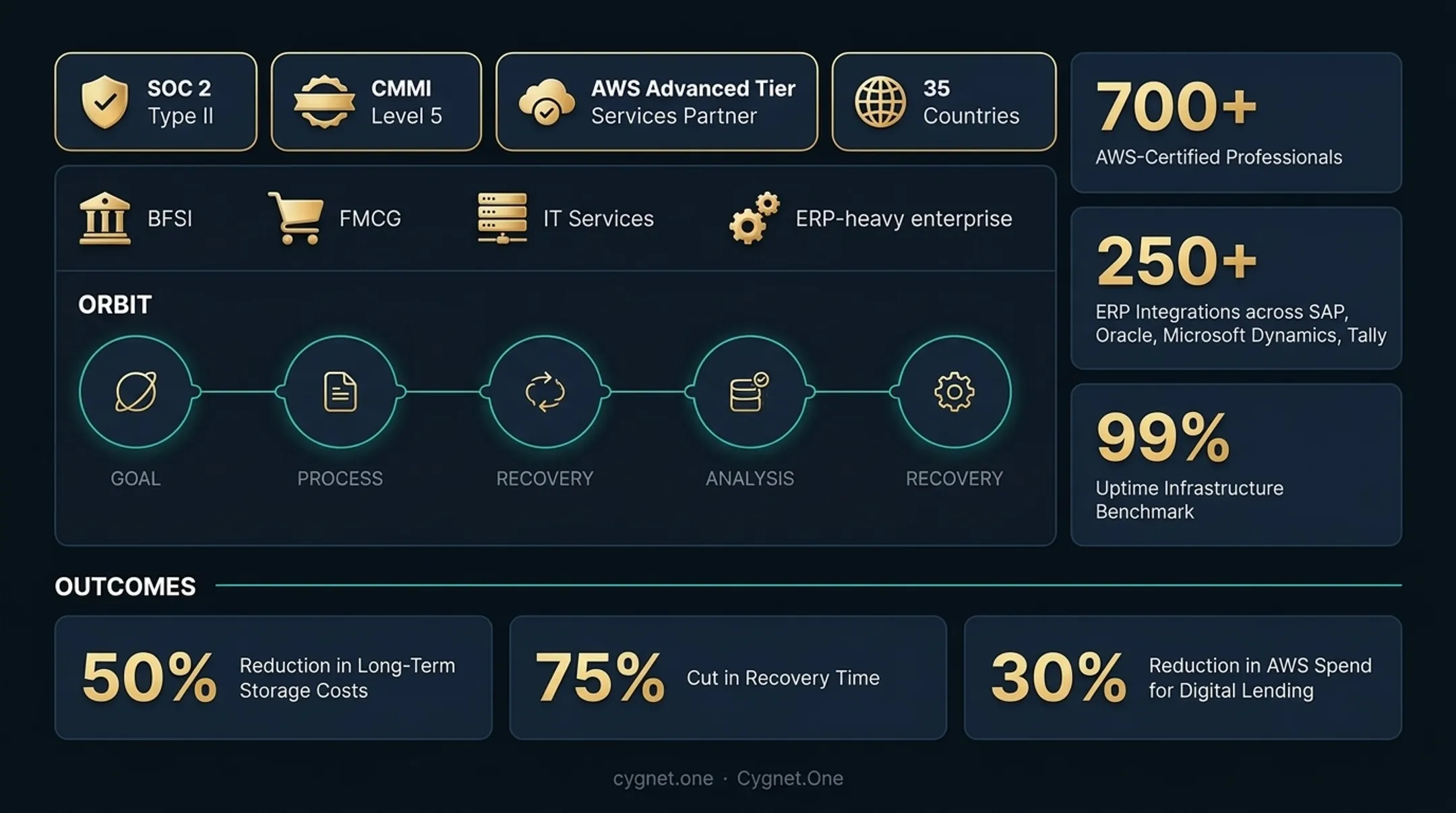

Cygnet.One is a 25-year technology transformation partner serving enterprises across 35 countries, holding CMMI Level 5 certification and SOC 2 Type II compliance. Their work spans BFSI, FMCG, IT Services, and ERP-heavy enterprise environments — the sectors where hybrid cloud complexity is highest due to compliance requirements, data sensitivity, and deep ERP dependency.
What distinguishes Cygnet.One in hybrid migration engagements:
- ORBIT framework — a documented, phased methodology covering assessment through post-migration optimization, with rollback procedures and automated testing gates at every stage
- AWS Advanced Tier Services Partner with 700+ AWS-certified professionals and competencies in Migration, DevOps, and Data & Analytics
- 250+ ERP integrations across SAP, Oracle, Microsoft Dynamics, and Tally — with automated testing capabilities that keep financial systems live throughout migration
- SOC 2 Type II, ISO 27001, CMMI Level 5 credentials aligned with regulated industry security standards
- 99% uptime infrastructure benchmarks and 24/7 managed application services post-go-live
- AWS Migration Acceleration Program (MAP) alignment, providing clients access to AWS-backed assessment tooling and potential migration funding

These capabilities translate directly to measurable outcomes. For BFSI clients, Cygnet.One has delivered a 50% reduction in long-term storage costs, 75% cut in recovery time, and 30% reduction in AWS spend for digital lending organizations.
Hybrid cloud migration is a continuous optimization process. The partner that fits your environment — one that understands your compliance requirements, workload profile, and operational model — will consistently outperform a generic engagement built around platform familiarity alone.
Request a migration readiness assessment from Cygnet.One to receive a transformation roadmap, risk matrix, and ROI projections tailored to your environment.
Frequently Asked Questions
What is hybrid cloud migration?
Hybrid cloud migration moves applications, workloads, and data across on-premises, private cloud, and public cloud environments — with deliberate placement decisions driven by performance, compliance, or cost. Unlike full cloud migration, some systems are intentionally kept on-premises.
What are the 7 cloud migration strategies?
The 7 Rs are: Rehosting, Replatforming, Repurchasing, Refactoring, Retiring, Retaining, and Reimagining. In hybrid migrations, organizations typically apply multiple strategies simultaneously across different workloads — a single uniform approach rarely fits a real enterprise environment.
How long does a hybrid cloud migration typically take?
Timelines vary significantly by environment complexity and scale. AWS prescriptive guidance gives a large-migration example of 1,000 servers over 6 months, with individual wave cycles typically spanning 4-6 weeks. Phased approaches starting with dev/test environments produce more predictable timelines than large-scale single-phase migrations.
Which workloads should stay on-premises in a hybrid cloud environment?
Workloads with sub-millisecond latency requirements, strict data residency regulations, rigid on-premises licensing constraints, or high refactoring costs are typically better retained on-premises. The decision should be based on a structured workload assessment — not default assumptions or migration convenience.
What should I look for when selecting a hybrid cloud migration partner?
Evaluate five criteria: end-to-end lifecycle capability (not just execution), security and compliance credentials, ERP and enterprise integration depth, a documented phased methodology with rollback capability, and post-migration managed services under defined SLAs.
How do you ensure security and compliance in a hybrid cloud migration?
Security must be built into the hybrid architecture from the start — not retrofitted after migration. Core requirements include zero-trust architecture, centralized monitoring, federated identity management, and compliance frameworks (GDPR, HIPAA, PCI-DSS, or regional equivalents) aligned to your industry before the first workload moves.
