Introduction
Most manufacturing teams struggle with SAP implementation not because the technology fails them, but because the scope is consistently underestimated. A deployment that touches production planning, supply chain, finance, quality, and regulatory compliance simultaneously is a fundamentally different challenge than a standard ERP rollout.
Manufacturers face unique pressures: multi-plant environments, real-time production scheduling, intricate Bills of Materials, shift-based workforces, and strict compliance mandates. When implementation is rushed or poorly scoped, the consequences compound quickly — data migration failures, low user adoption, costly rework, and production disruptions that erode ROI before go-live.
Over 60% of S/4HANA transformation projects report deviations in budget, schedule, and quality, with projects taking 30% longer than planned on average. This guide covers the essential modules, five implementation stages, common pitfalls, and best practices for a successful manufacturing SAP deployment.
TL;DR
- Cross-functional planning is mandatory before a single line of configuration is written
- Module selection (PP, QM, PM, SCM, S/4HANA) must align with your production model and operational priorities
- The proven deployment path follows five stages: Preparation, Blueprinting, Realization, Testing, and Go-Live
- Most failures trace back to poor data quality, weak change management, or underestimated integration complexity
- Post go-live optimization determines whether the investment actually delivers ROI
What Makes SAP Implementation in Manufacturing Complex
Manufacturing environments are operationally distinct from other industries. Multi-plant operations, real-time production scheduling, Bill of Materials (BOM) complexity, and shift-based workforces each add configuration layers that simply don't exist in a services business. Add regulatory compliance — quality standards, tax mandates, e-invoicing requirements — and the implementation scope expands further.

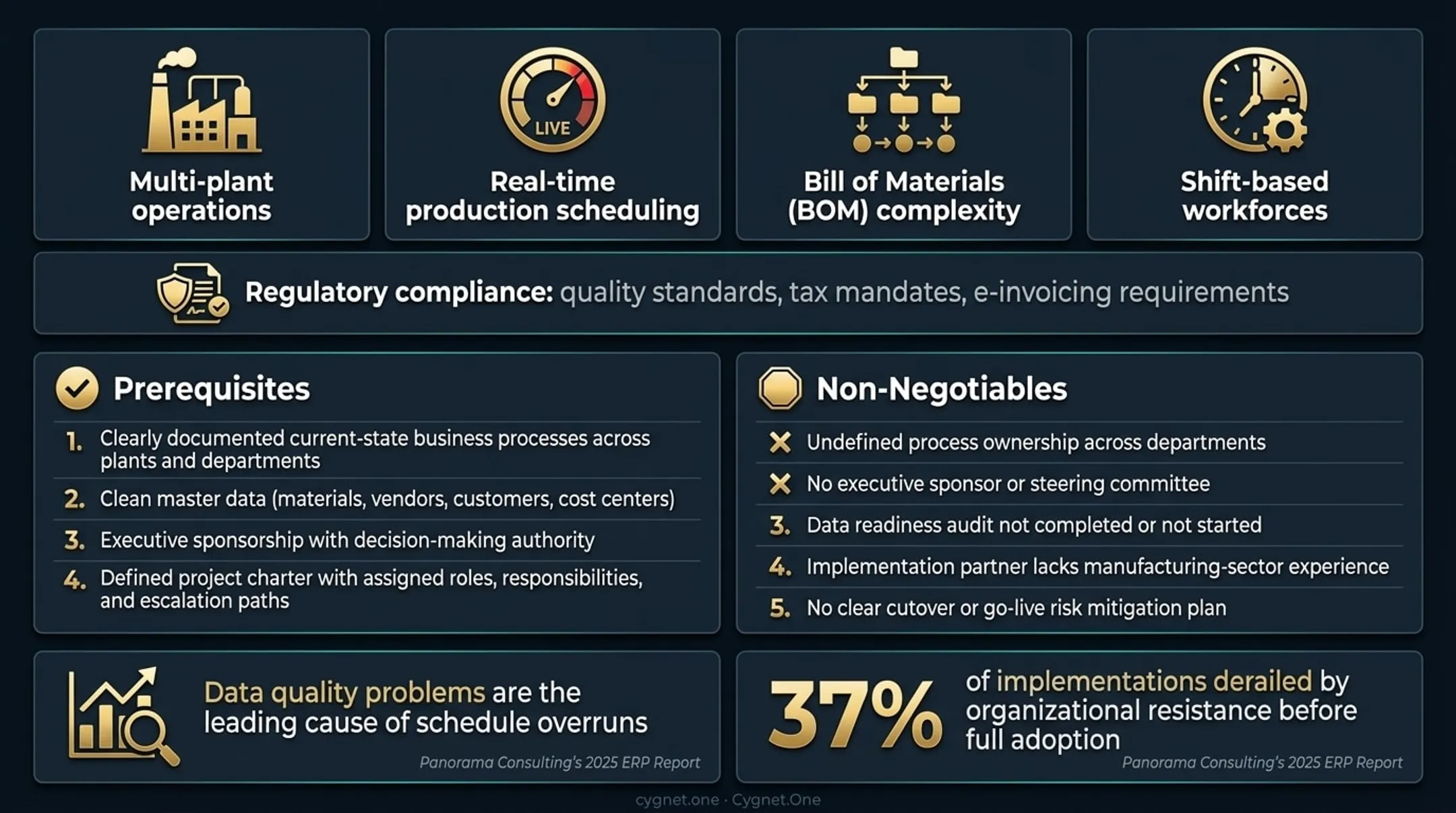

Key prerequisites that must be in place before implementation begins:
- Clearly documented current-state business processes across plants and departments
- Clean master data (materials, vendors, customers, cost centers)
- Executive sponsorship with decision-making authority
- Defined project charter with assigned roles, responsibilities, and escalation paths
Non-negotiables — conditions under which implementation should NOT proceed:
- Undefined process ownership across departments
- No executive sponsor or steering committee
- Data readiness audit not completed or not started
- Implementation partner lacks manufacturing-sector experience
- No clear cutover or go-live risk mitigation plan
Skipping these steps has a measurable cost. According to Panorama Consulting's 2025 ERP Report, data quality problems are the leading cause of schedule overruns — and organizational resistance derails 37% of implementations before they reach full adoption.

Key SAP Modules for Manufacturing
The core SAP module stack solves specific operational problems. Each module addresses a distinct manufacturing challenge:
SAP S/4HANA: The Digital Core
Integrates finance, logistics, and production in real time with embedded analytics and AI. S/4HANA uses Core Data Services (CDS views) to provide multidimensional reports and dashboards without data replication, enabling insight-to-action capabilities directly within the ERP.
SAP Production Planning (PP)
Manages MRP, capacity planning, shop floor control, and production scheduling. In S/4HANA, this includes constraint modeling and advanced scheduling algorithms. PP spans three operational layers:
- Production Engineering: BOMs, routings, and work center configuration
- Production Planning: Material availability and demand-driven scheduling
- Production Operations: Shop floor execution and real-time control
SAP Plant Maintenance (PM)
Handles preventive and predictive maintenance to reduce equipment downtime. PM supports planning, processing, and settlement of maintenance tasks, providing clear visibility into maintenance processes for decision-making on technical systems and replacement investments.
SAP Quality Management (QM)
Enforces quality inspection workflows from raw material intake to finished goods delivery. QM supports ISO 9000 and other compliance standards across the full quality lifecycle:
- Quality planning and assurance
- Inspection control and defect recording
- Continuous improvement and audit management
SAP Supply Chain Management (SCM)
Covers procurement, demand planning, warehouse management, and logistics. Key components include Integrated Business Planning (IBP) for sales and operations planning and Extended Warehouse Management (EWM) for complex distribution needs.

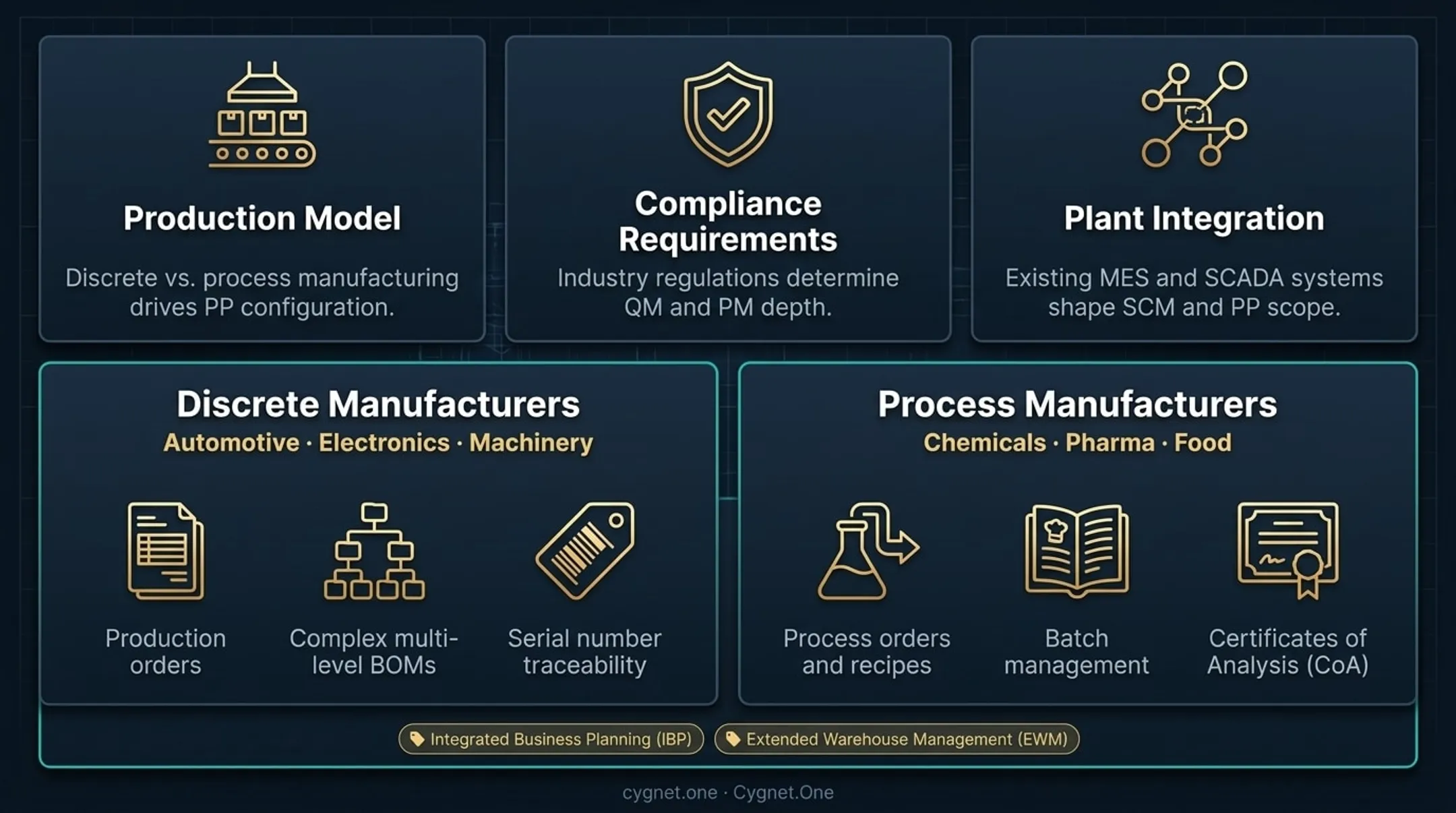

Choosing the right modules depends on your manufacturing model and integration landscape. Key selection factors:
- Production model: Discrete vs. process manufacturing drives PP configuration
- Compliance requirements: Industry regulations determine QM and PM depth
- Plant integration: Existing MES and SCADA systems shape SCM and PP scope
Discrete manufacturers (automotive, electronics, machinery) prioritize production orders, complex multi-level BOMs, and serial number traceability. Process manufacturers (chemicals, pharma, food) focus on process orders, recipes, batch management, and Certificates of Analysis (CoA).

The 5 Stages of SAP Implementation in Manufacturing
A typical manufacturing SAP rollout spans 6–18 months depending on scope, number of plants, and legacy system complexity. Shortcuts in any stage resurface as costly problems post go-live. The framework aligns with SAP's Activate methodology, which emphasizes fit-to-standard processes to minimize customization.
Stage 1: Project Preparation
Timeline: 4-6 weeks
Critical activities:
- Define scope, objectives, budget, and timeline with measurable KPIs
- Establish steering committee with business and IT leadership
- Confirm implementation partner's manufacturing credentials
- Conduct system landscape assessment to identify integration touchpoints with existing ERP, MES, or SCADA systems
- Assign data stewards per domain (materials, vendors, cost centers)
Executive sponsorship is non-negotiable. Projects without strong leadership support face organizational resistance that derails adoption.
Stage 2: Business Blueprinting
Timeline: 8-12 weeks
Critical activities:
- Map current ("as-is") manufacturing processes to SAP's standard processes ("to-be")
- Cover production planning, procurement, quality, and maintenance workflows
- Identify gaps where custom configuration or bolt-on solutions are needed
- Document configuration requirements for each module selected
- Validate blueprint with process owners and plant managers before advancing
Prioritize fit-to-standard during this phase. 44% of companies cite customizations as a major migration barrier, and custom code compounds long-term maintenance costs with every future upgrade.
Stage 3: Realization (Configuration and Development)
Timeline: 12-20 weeks
Critical activities:
- Execute system configuration based on approved blueprint
- Develop required custom reports, forms, or interfaces
- Integrate SAP with third-party systems (plant-floor MES, e-invoicing platforms, tax compliance systems)
- Perform unit testing of each configured process in isolation to catch errors early
For manufacturers operating in India, UAE, or Saudi Arabia, this stage must include integration with mandatory e-invoicing platforms. Cygnet.One holds government-backed credentials across these markets — approved IRP and GSP in India, FTA-recognized in UAE, and ZATCA-recognized in Saudi Arabia — which simplifies compliance wiring during the realization build.
Stage 4: Testing and User Training
Timeline: 8-12 weeks
Critical activities:
- Run integration testing to validate end-to-end manufacturing processes (order-to-delivery, procure-to-pay, plan-to-produce)
- Conduct User Acceptance Testing (UAT) with actual plant floor and back-office users
- Run parallel production data in both legacy and SAP systems to validate data accuracy
- Deliver role-based training tailored to shop floor operators, planners, procurement teams, and finance staff
Training timed too close to go-live — or built on generic scenarios rather than real plant workflows — is one of the leading causes of poor adoption. Appoint SAP champions (super users) per department to provide peer support both during cutover and in the weeks after.

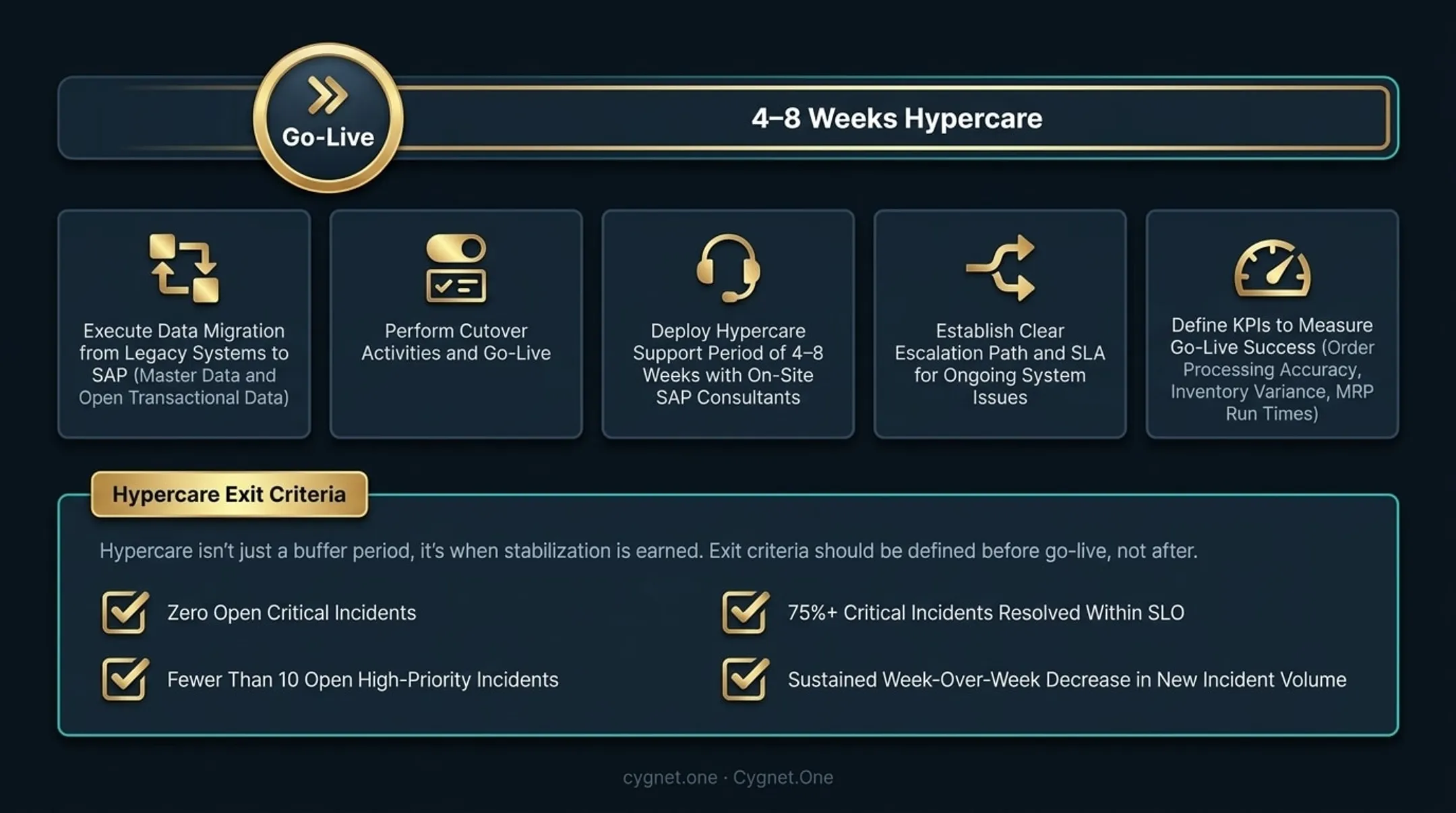

Stage 5: Go-Live and Post Go-Live Support
Timeline: Go-live event + 4-8 weeks hypercare
Critical activities:
- Execute data migration from legacy systems to SAP (master data and open transactional data)
- Perform cutover activities and go-live
- Deploy hypercare support period of 4–8 weeks with on-site SAP consultants
- Establish clear escalation path and SLA for ongoing system issues
- Define KPIs to measure go-live success (order processing accuracy, inventory variance, MRP run times)

Hypercare isn't just a buffer period — it's when stabilization is earned. Exit criteria should be defined before go-live, not after.
Hypercare exit criteria should include:
- Zero open critical incidents
- Fewer than 10 open high-priority incidents
- 75%+ critical incidents resolved within SLO
- Sustained week-over-week decrease in new incident volume
Common SAP Implementation Challenges and How to Overcome Them
Poor Data Quality at Migration
Problem: Incorrect, duplicate, or incomplete master data (materials, BOMs, vendor records) migrated into SAP causes cascading errors in production planning and procurement runs.
Likely cause: Underestimating data cleansing effort and not assigning dedicated data stewards per domain before migration begins.
Fix: Run a data quality audit and cleansing exercise 3–4 months before go-live. Validate migrated data with plant process owners through structured sign-off workshops, not just IT checks. Underestimated testing and data migration phases are a primary reason for quality deficiencies after go-live.
Low User Adoption on the Shop Floor
Problem: Production planners, maintenance teams, and warehouse staff revert to manual workarounds or legacy spreadsheets, undermining SAP data accuracy.
Likely cause: Training delivered too close to go-live, too generic, and not tied to users' actual daily transactions.
Fix: Design role-based training using real production scenarios from the user's plant. Appoint SAP champions (super users) per department who provide peer support during and after go-live. Organizational change management is consistently underfunded in ERP projects—and shop-floor resistance is often the consequence when it is.
Integration Failures with Plant-Floor Systems
Problem: SAP fails to receive real-time production data from MES, SCADA, or IoT sensors, creating reporting gaps and manual reconciliation overhead.
Likely cause: Integration architecture not defined during blueprinting; middleware or API mapping left as an afterthought.
Fix: Map all system integration requirements in Stage 2 (Blueprinting). Validate integration layers during Stage 3 testing before UAT. Integration is cited as a top barrier by 49% of companies, particularly for manufacturers integrating IT systems with OT on the factory floor.
Ensure compliance-critical integrations (e-invoicing, tax reporting) are tested separately against regulatory requirements—especially critical for manufacturers operating across India, UAE, or Saudi Arabia with mandatory e-invoicing mandates. Getting these right before go-live prevents costly post-launch remediation and keeps regulatory exposure in check.
Best Practices for a Successful SAP Implementation in Manufacturing
Keep Scope Lean and Phased
Avoid implementing every module simultaneously. Prioritize modules addressing your highest-pain manufacturing processes first (typically PP + MM + FI), then extend to QM, PM, and SCM in subsequent phases.
55% of companies exceed their original budget, with the leading cause being the "unexpected need for additional technology." A phased approach reduces risk and applies learnings from initial phases to subsequent rollouts.
Insist on Process Standardization Before Configuration
SAP implementation should not digitize broken processes. Conduct a lean process review before blueprinting to eliminate redundant steps, standardize workflows across plants, and reduce custom development requirements. Custom code increases implementation cost and long-term maintenance burden.
Choose an Implementation Partner with Manufacturing-Sector Depth
General SAP experience isn't enough. Look for a partner with demonstrated manufacturing use cases — FMCG, consumer goods, industrial — and the ability to handle compliance requirements such as GST, VAT, and e-invoicing that commonly surface mid-implementation.
Compliance complexity is particularly acute for manufacturers operating across India, UAE, and Saudi Arabia. Cygnet.One, for example, holds GSTN-approved IRP and GSP status, FTA recognition in UAE, and ZATCA recognition in Saudi Arabia — credentials that matter when regulatory requirements hit unexpectedly during go-live.
Build a Formal Change Management Program
Assign a dedicated change manager from Day 1. Core responsibilities should include:
- Communicating the implementation timeline and impact to all organizational levels
- Running structured training sessions before each phase go-live
- Creating feedback loops where plant staff can raise adoption challenges early, without fear of project pressure

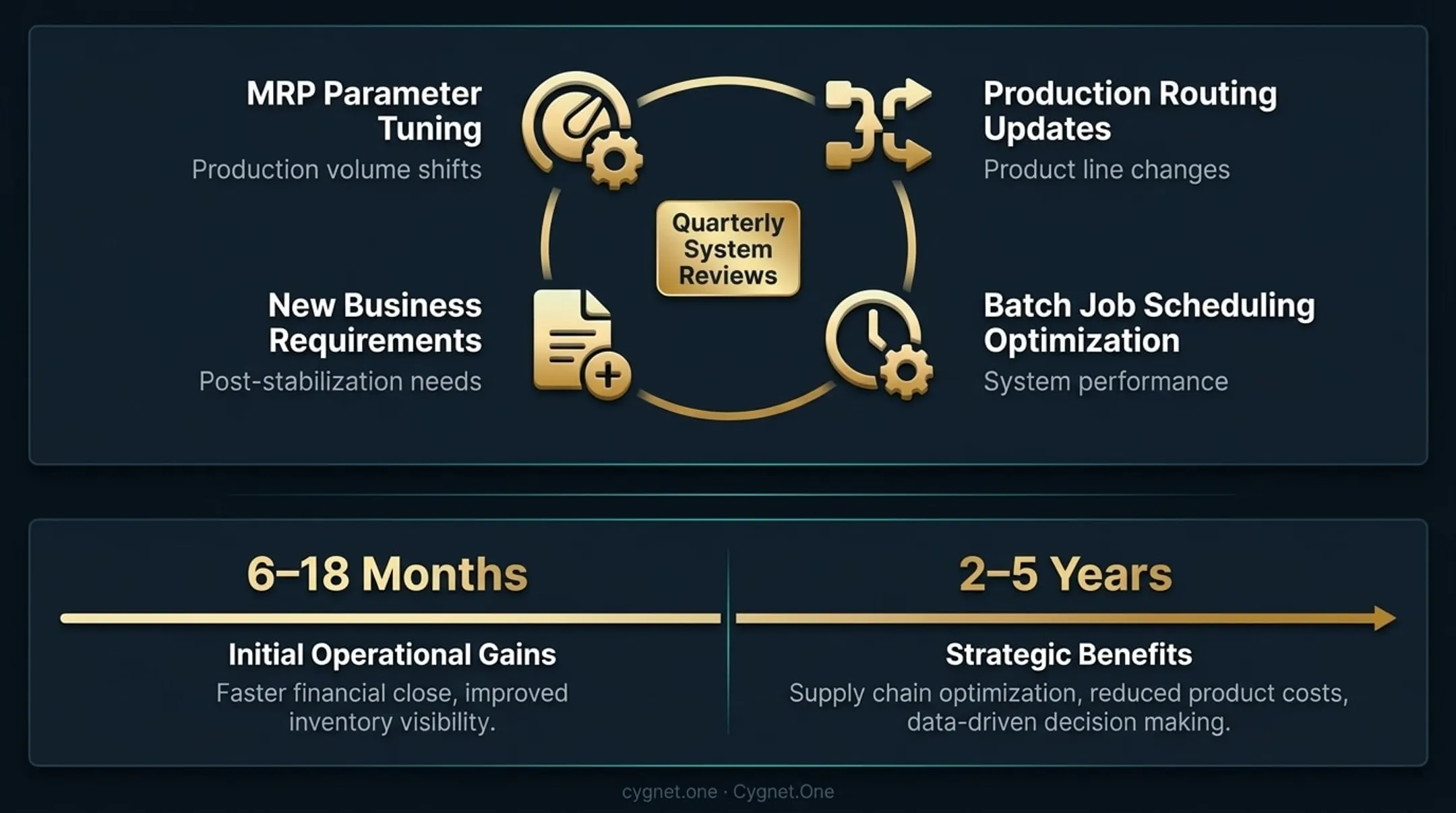

Plan for Post Go-Live Optimization, Not Just Maintenance
SAP go-live is not the finish line. Schedule quarterly system reviews to address:
- MRP parameter tuning as production volumes shift
- Production routing updates when product lines change
- Batch job scheduling optimization for system performance
- New business requirements that emerge after initial stabilization
ROI realization typically follows a two-stage pattern: initial operational gains within 6–18 months (faster financial close, improved inventory visibility) and strategic benefits over 2–5 years (supply chain optimization, reduced product costs, data-driven decision making).

Frequently Asked Questions
Which SAP modules are used in the manufacturing industry?
Core modules include SAP S/4HANA as the digital core, PP for production planning, PM for plant maintenance, QM for quality management, and SCM for supply chain. The right mix depends on whether you run discrete or process manufacturing, and which operational gaps matter most.
What are the 5 stages of SAP implementation?
The five stages are Project Preparation, Business Blueprinting, Realization (configuration), Testing and Training, and Go-Live with post go-live support. Each stage gates the next — skipping Business Blueprinting is the most common shortcut that leads to costly rework during Realization.
What are the 4 pillars of SAP?
SAP's four strategic pillars are SAP S/4HANA (the intelligent ERP core), SAP Business Technology Platform (BTP for integration and extensions), RISE with SAP (cloud transformation for existing customers), and GROW with SAP (packaged offering for mid-market companies).
How long does SAP implementation take in a manufacturing company?
A single-plant implementation of core modules typically takes 6–9 months. Multi-plant or global rollouts range from 12–24 months. Scope, data readiness, and integration complexity are the primary drivers.
What is the biggest risk in SAP implementation for manufacturers?
Poor data quality and low user adoption cause most SAP implementation failures. Both are preventable: start data cleansing 3–4 months before go-live, and tie user training directly to real manufacturing workflows rather than generic system demos.
