Introduction
Enterprise cloud migration is a multi-phase strategic initiative spanning applications, data, infrastructure, people, and processes. Without a structured plan, that complexity becomes one of the leading causes of cost overruns and operational disruption.
The numbers bear this out. According to Flexera's 2025 State of the Cloud report, organizations exceed their public cloud budgets by an average of 17%. McKinsey research puts the problem in sharper relief: migration projects run 14% over budget annually, and 38% are delayed by more than a quarter.
This guide is designed for enterprise IT leaders, CIOs, and digital transformation teams who need a proven roadmap. It covers:
- What a cloud migration strategy actually entails
- Established frameworks, including the 7 Rs
- A step-by-step execution approach
- The most common failure points — and how to avoid them
TL;DR
- Cloud migration strategy is a structured plan to move workloads, data, and apps to the cloud with minimal disruption
- The "7 Rs" framework (Rehost, Replatform, Refactor, Rearchitect, Replace, Retain, Retire) guides workload-by-workload decisions
- Phased execution — assessment → strategy → architecture → implementation → optimization — is non-negotiable
- Skipping assessment, underestimating TCO, and treating go-live as the finish line are the most common failure modes
- Compliance, security, and ERP integration carry the highest risk and need explicit planning from day one
What Is Enterprise Cloud Migration Strategy?
Enterprise cloud migration strategy is a documented, organization-wide plan that defines which workloads move to the cloud, in what sequence, using which migration approach, and how success will be measured — all tied to specific business goals. Done right, it delivers measurable returns:
- Reduced infrastructure costs through optimized resource utilization
- Improved scalability to handle fluctuating demand
- Greater business agility for faster time-to-market
- Enhanced disaster recovery and business continuity
- Access to cloud-native capabilities like AI, automation, and managed services
This is fundamentally different from simply "moving servers to the cloud." A true enterprise migration strategy accounts for dependencies, regulatory constraints, workforce readiness, integration complexity, and long-term cloud governance — factors that grow far harder to manage at scale without upfront planning.
Without that structure, workloads get migrated quickly but run inefficiently, often costing more than the legacy environment they replaced.
Why Enterprises Need a Cloud Migration Strategy
Business Drivers at Enterprise Scale
Cloud migration has become a strategic imperative. According to Flexera's 2026 State of the Cloud report, 73% of all organizations and 78% of large enterprises now operate hybrid cloud estates, with public cloud workloads growing from 52% to 54% year-over-year.
The primary drivers include infrastructure cost reduction, remote workforce scalability, AI/ML adoption readiness, and regulatory compliance.
At enterprise scale, these stakes are higher. The FinOps Foundation reports that 31% of large organizations spend over $50 million annually on public cloud services — at that level, even marginal inefficiency compounds fast.
IDC's 3Q24 Cloud Pulse survey reinforces the urgency: 60% of cloud buyers believe their IT infrastructure requires major transformation, and 82% say their existing cloud environment needs modernization.
What Goes Wrong Without a Strategy
Enterprises that rush migration without proper assessment commonly face:
- Unplanned downtime: McKinsey found that 38% of companies experienced migration delays of more than one quarter, indicating significant operational disruption
- Budget overruns: The 2025 DevOps Migration Index revealed that 77% of migration projects exceeded budgets by more than 10%, with an average overage of 18%
- Performance degradation: Incomplete dependency mapping and missed integrations cause application failures
- Compliance gaps: Moving regulated data without addressing data sovereignty, encryption, and audit requirements creates legal exposure
A structured strategy is what separates migrations that deliver on their business case from those that quietly drain it.
Compliance as a Strategic Driver
For enterprises in regulated industries — finance, healthcare, government — cloud migration brings mandatory compliance requirements around data sovereignty, encryption, and auditability. These aren't items to address after go-live.
Gartner predicts that over 50% of multinational organizations will have established digital sovereignty strategies by 2029. For regulated businesses, that makes compliance a day-one architectural decision.

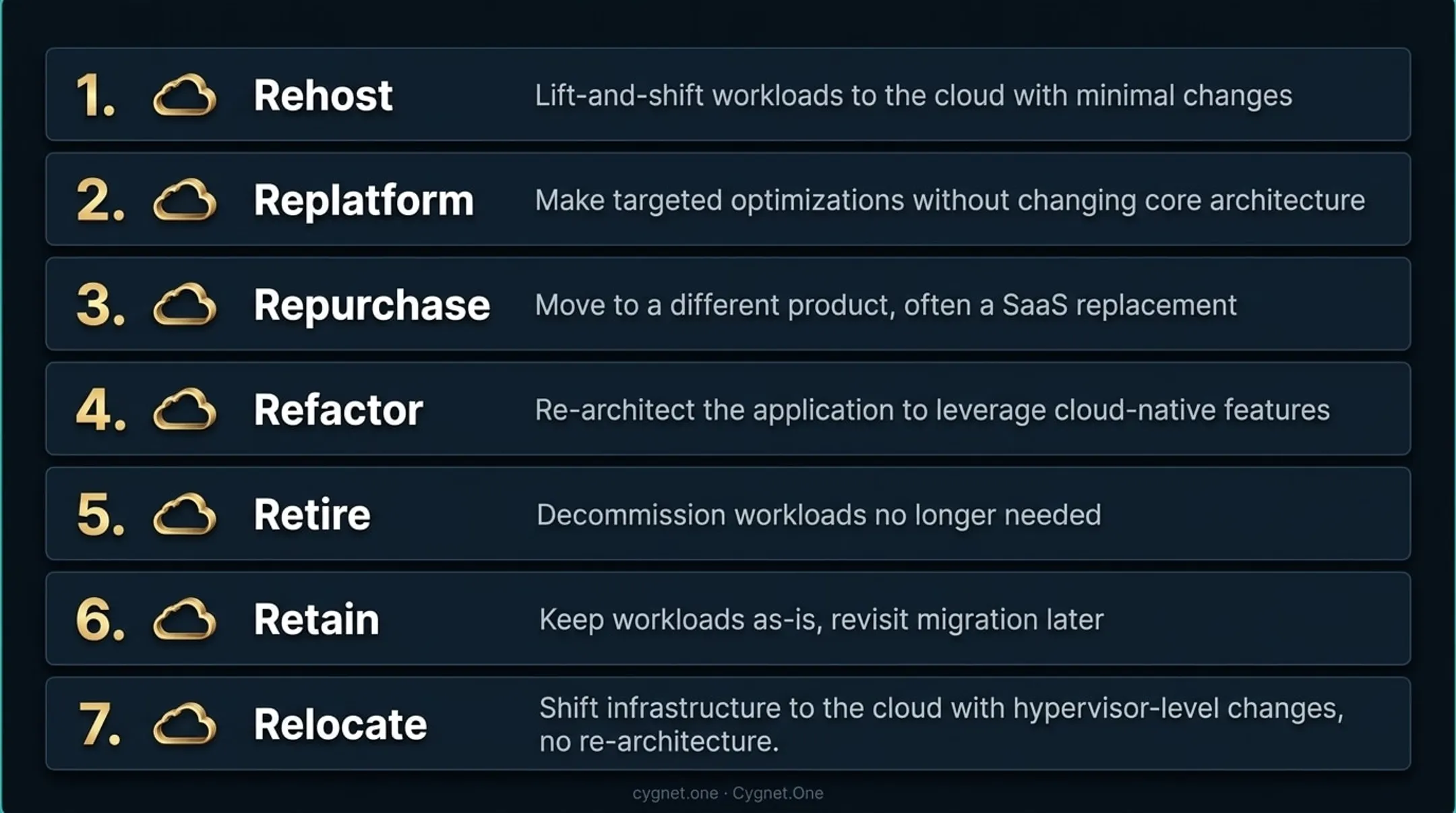

The 7 Rs of Enterprise Cloud Migration
The 7 Rs framework is the foundational decision-making model for enterprise migrations. Before executing any migration, each workload must be evaluated and assigned one of seven strategic treatments. Most enterprise portfolios require a mix of strategies across workloads.
The table below offers a quick-reference view before diving into each strategy in detail:
| Strategy | Core Action | Best For |
|---|---|---|
| Rehost | Move as-is | Stable workloads, fast timelines |
| Replatform | Targeted infra changes | PaaS benefits with moderate effort |
| Refactor | Modernize code structure | Efficiency and maintainability gains |
| Rearchitect | Redesign architecture | Scalability, microservices, serverless |
| Replace | Switch to SaaS | Legacy apps with modern equivalents |
| Retire | Decommission | Redundant or underused workloads |
| Retain | Keep on-premises | Regulatory, dependency, or ROI constraints |

Rehost (Lift and Shift)
Rehosting moves workloads to the cloud with no code or architecture changes — the fastest and lowest upfront-cost path. It's best suited for stable workloads with no near-term modernization plans.
That said, rehosting carries forward all existing technical debt. Workloads migrated this way often incur higher-than-expected cloud costs because they weren't designed for cloud pricing models — making it a migration tactic, not an optimization strategy.
Replatform (Lift, Tinker, and Shift)
Replatforming makes targeted infrastructure changes — such as moving a SQL Server VM to Amazon Aurora — to reduce operational overhead without rewriting the application. It's the right choice when the goal is PaaS benefits (automatic patching, backups, high availability) with moderate effort.
Refactor and Rearchitect
Refactor modernizes the code structure without adding features — improving efficiency and maintainability. Rearchitect redesigns the application architecture, such as breaking a monolith into microservices or adopting serverless computing.
Both strategies require more effort but deliver stronger long-term returns — suited to workloads where scalability, performance, or cloud-native capabilities are the goal.
Replace (Repurchase) and Retire
Replace involves switching to a SaaS equivalent, such as moving a legacy CRM to Salesforce or an on-premises email server to Microsoft 365. This eliminates the need to manage infrastructure entirely.
Retire decommissions workloads that are redundant, underused, or no longer deliver business value. AWS Prescriptive Guidance states that it's not unusual to find more than 10% of workloads in an enterprise IT portfolio can be turned off, with some organizations identifying 10–30% as retirement candidates during assessments.
Retain
Some workloads must stay on-premises due to regulatory constraints, unresolved physical dependencies, or low ROI from migration. A mature strategy explicitly plans for retained workloads rather than forcing everything to the cloud.
Tools like Azure Arc allow unified management of retained on-premises workloads alongside cloud-hosted ones — providing centralized governance, policy enforcement, and security posture management across hybrid environments.
How to Choose the Right R
The decision should be driven by three factors:
- Business driver: Why does this workload need to change?
- Technical fitness: Compatibility, dependencies, and performance characteristics
- Organizational capacity: Timeline and resource availability for modernization
Step-by-Step Enterprise Cloud Migration Framework
Regardless of which Rs are chosen, every enterprise cloud migration follows the same underlying sequence of phases. Skipping or rushing early phases is the single most reliable predictor of migration failure.

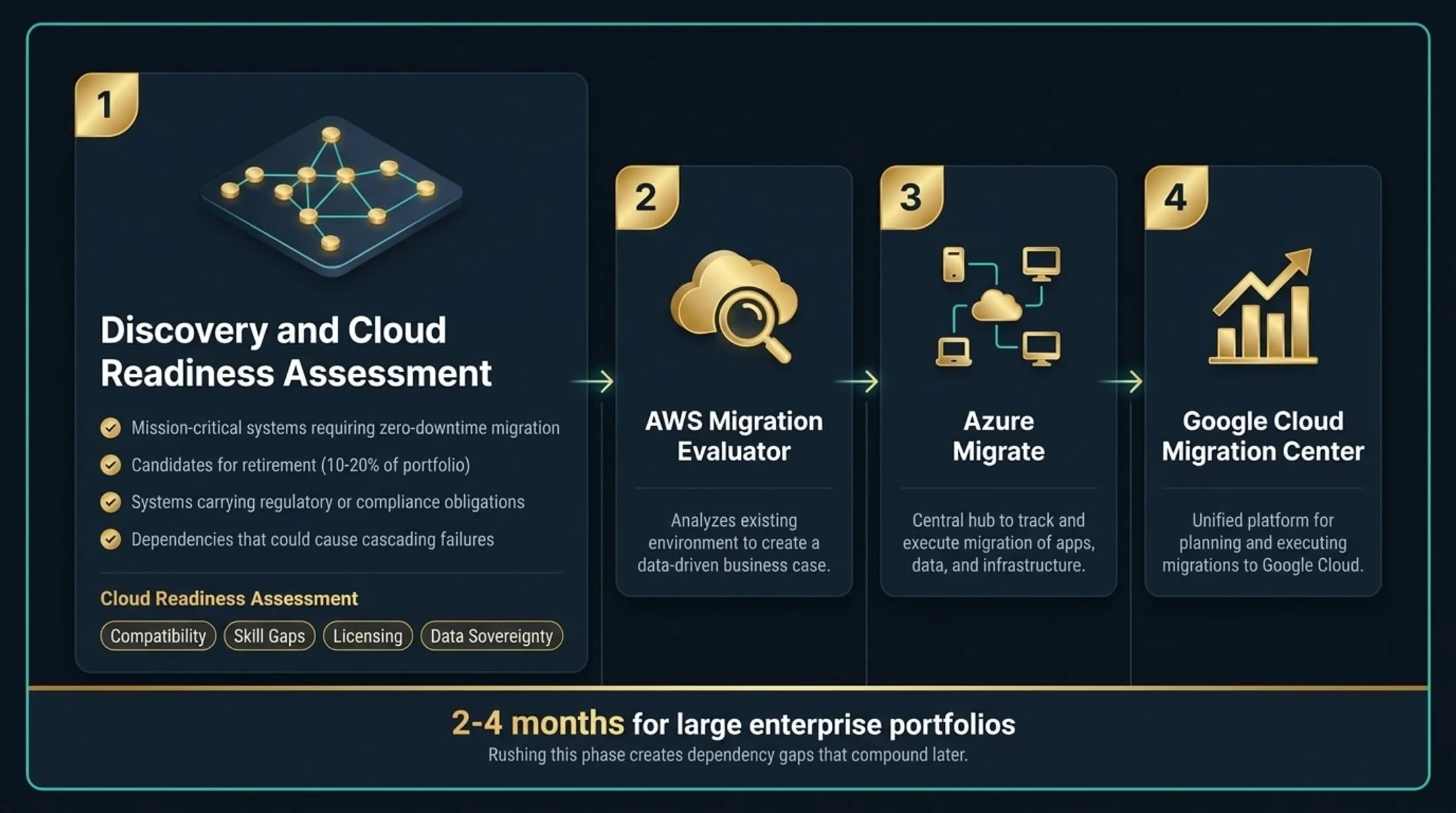

Step 1: Discovery and Cloud Readiness Assessment
Conduct a comprehensive inventory of all existing workloads, applications, data repositories, dependencies, integration points, and security configurations. This is both a technical exercise and a business mapping exercise that identifies:
- Mission-critical systems that require zero-downtime migration
- Candidates for retirement (often 10-20% of the portfolio)
- Systems carrying regulatory or compliance obligations
- Application dependencies that could cause cascading failures
Cloud readiness assessment:
Evaluate application compatibility, team skill gaps, licensing issues, and data sovereignty requirements. Major cloud providers offer structured readiness assessment tools:
- AWS Migration Evaluator: Agentless discovery, utilization analysis, and TCO business case generation
- Azure Migrate: Centralized hub with dependency visualization and integrated business case features
- Google Cloud Migration Center: Unified platform for asset discovery and ROI analysis
Plan for 2-4 months in large enterprise portfolios — rushing this phase creates dependency gaps that compound later.

Step 2: Define Goals, KPIs, and Select Migration Strategies
Set measurable migration goals tied to specific business outcomes:
- Reduce infrastructure costs by X%
- Improve application uptime to Y%
- Enable remote access for Z users
- Accelerate deployment frequency by N days
Define the KPIs that will prove those outcomes post-migration. This step is where leadership buy-in is secured by connecting cloud investment to business value.
Assign migration strategies:
Map each workload to one of the 7 Rs based on its business driver, technical profile, and modernization timeline. This produces a prioritized workload migration backlog ordered by risk level and business impact.
Step 3: Design Target Architecture and Build the Business Case
Design the target cloud architecture covering:
- Which cloud model fits your risk and control requirements: public, private, hybrid, or multicloud
- Which provider — AWS, Azure, GCP, or a combination — aligns with your workload profile
- How your network topology (VPC design, connectivity, security zones) will be structured
- How identity management, encryption, and access controls will be enforced
- How API gateways, middleware, and data synchronization will handle integration
For enterprises with complex ERP, finance, or tax systems, this is the stage to plan integration with existing platforms to avoid data silos post-migration. Integration complexity here is consistently underestimated — mapping dependencies across SAP, Oracle, or Microsoft Dynamics environments while maintaining data continuity across cloud and on-premises systems requires deliberate planning. Cygnet.One has delivered 250+ such ERP integrations across these environments, which informs how granular this dependency mapping needs to be.
Build the business case:
Document expected costs using cloud pricing calculators (AWS Pricing Calculator, Azure Pricing Calculator, Google Cloud Pricing Calculator), projected TCO versus on-premises, timeline, risk register, and compliance requirements. For enterprises operating across multiple regulatory jurisdictions, data residency and audit trail obligations must be explicitly addressed.

Step 4: Execute Migration in Phases
Implement the migration in defined waves, starting with low-risk, low-dependency workloads to build team experience and validate the migration process before moving business-critical systems.
Each wave should include:
- Defined cutover plan with rollback procedures
- User communication protocol
- Performance baseline measurements established before migration begins
- Parallel-run periods for critical systems to validate functionality
- Disaster recovery plans tested before go-live
- Source environment set to read-only before final cutover to prevent data divergence
The Microsoft Cloud Adoption Framework recommends wave-based execution to reduce risk, allow teams to learn from initial deployments, and refine runbooks and processes over time. This approach significantly reduces the likelihood of unplanned downtime and major operational disruptions.

Step 5: Validate, Optimize, and Govern Post-Migration
After each migration wave, conduct structured validation with actual end users, verifying that workflows, integrations, and performance meet or exceed the pre-migration baseline. Treat any gap as a blocking issue before proceeding to the next wave.
Establish ongoing cloud governance:
- Performance monitoring: Real-time dashboards and alerting
- Cost optimization: Regular reviews using cloud-native tools and third-party cost management platforms
- Security posture assessments: Continuous compliance monitoring
- Regular review cycle: Reassess retained workloads as constraints evolve
Enterprises that stop at day-one cutover typically spend the next 12-18 months chasing performance issues, runaway costs, and monitoring gaps they didn't anticipate. The governance framework built in this phase determines whether cloud delivers on its business case — or just shifts the same operational debt to a different platform.
Common Challenges, Misconceptions, and Best Practices
"Lift and Shift Is Good Enough"
Many enterprises choose rehosting for the majority of their workload portfolio because it is fast, then discover post-migration that cloud costs are higher than expected. The cause: workloads were never optimized for cloud pricing models.
Best practice: Use rehosting deliberately as a first step, then plan for a modernization wave after initial migration. This two-phase approach balances speed with long-term optimization.
"Cloud Is Automatically Cheaper"
Cloud cost overruns are among the most reported post-migration pain points. Flexera's 2025 State of the Cloud report found that organizations estimate 29% of their cloud spend is wasted, a figure that has been increasing year-over-year.
Primary causes:
- Oversized instances that replicate on-premises server specifications without rightsizing
- Idle resources left running when not in use (dev/test environments, unattached storage)
- Misconfigured autoscaling that fails to scale down during low demand
Best practice: Build cloud cost governance (FinOps) into the migration plan from the start. The FinOps Foundation reports that 63% of organizations now have a dedicated FinOps team, with workload optimization and waste reduction as the top priority.
Security and Compliance Complexity
Moving to the cloud changes the security responsibility model. Enterprises remain responsible for what runs in the cloud, while the provider secures the underlying infrastructure. For enterprises operating in regulated industries or multiple geographies, this shared responsibility model must be mapped against specific compliance requirements before migration begins.
Key requirements:
- Data encryption at rest and in transit
- Granular access controls and identity management
- Audit logging and compliance reporting
- Data residency and sovereignty for regulated data
Engage compliance and security teams during architecture design (Step 3), not after migration. Cloud providers offer specific compliance pages, region controls, and contractual agreements (like Business Associate Addendums for HIPAA) to help customers meet these obligations.
Migration Completion ≠ Cloud Readiness
Completing the technical migration of workloads is not the same as being cloud-ready. Enterprises that treat day-one cutover as the finish line often struggle with poor application performance, inadequate monitoring, and unoptimized costs for 12–18 months post-migration.
Migration is the beginning, not the end. A continuously managed, optimized cloud environment requires an ongoing operating model — governance, cost oversight, and performance tuning built into day-to-day operations. Cloud Centers of Excellence (CCOEs) formalize this: 71% of organizations have established one to own cloud strategy and optimization post-migration.
Vendor Lock-In and Data Interoperability
Cloud providers offer powerful proprietary services, but over-reliance on them can make future migration or multi-cloud strategies difficult.

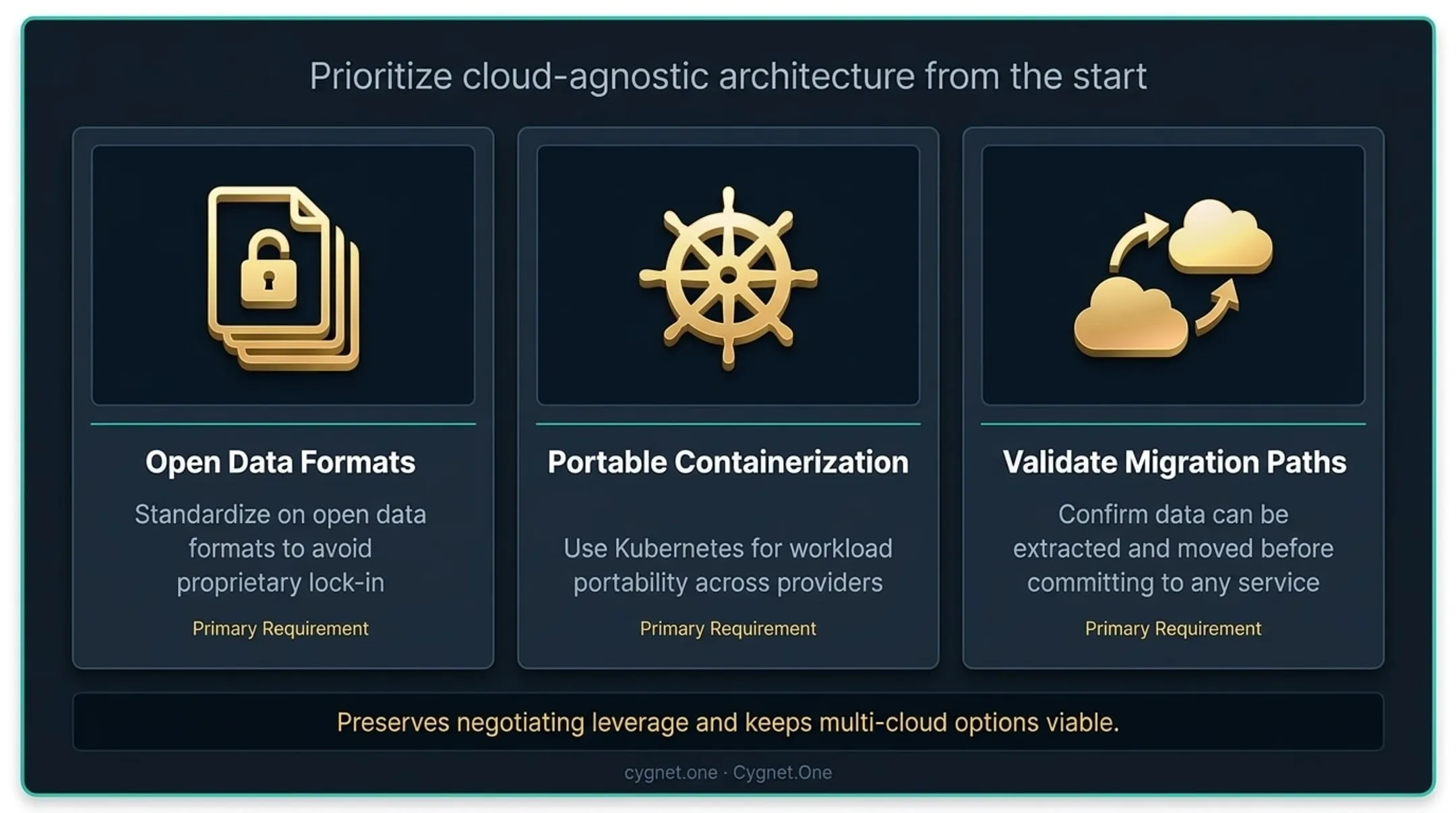

Prioritize cloud-agnostic architecture from the start:
- Standardize on open data formats to avoid proprietary lock-in
- Use portable containerization (Kubernetes) for workload portability
- Validate that data can be extracted and migrated between providers before committing to any service

This preserves negotiating leverage and keeps future multi-cloud or provider-switch options viable — decisions that are far harder to reverse once deeply embedded in proprietary services.
Frequently Asked Questions
What are the common enterprise cloud migration strategies (the 'R's)?
The 7 Rs are Rehost (lift and shift with no changes), Replatform (targeted infrastructure optimizations), Refactor (code modernization), Rearchitect (redesign for cloud-native), Replace (switch to SaaS), Retire (decommission), and Retain (keep on-premises). Each represents a different approach ranging from no-change moves to full cloud-native rebuilds.
What is the difference between rehosting and replatforming in cloud migration?
Rehosting moves workloads to the cloud without any changes (lift and shift), maintaining the same architecture and configuration. Replatforming introduces targeted infrastructure changes—such as moving to a managed database service—to gain cloud benefits like automatic patching and high availability without a full application rewrite.
How long does an enterprise cloud migration typically take?
Timelines vary significantly based on portfolio size and complexity, but enterprise migrations commonly run from 12 to 36 months when using a phased, wave-based approach. The assessment and planning phase alone often takes 2-4 months for extensive portfolios.
What should enterprises assess before starting cloud migration?
Before migrating, enterprises should inventory all workloads, map application dependencies, evaluate compliance and data residency requirements, identify team skill gaps, and compare total cost of ownership between on-premises and cloud environments. Skipping this discovery phase is the most common cause of missed dependencies and cost overruns.
How do you measure the success of a cloud migration?
Measure success against pre-defined KPIs tied to original business goals: infrastructure cost reduction, application uptime, response time, and deployment frequency. Establish baseline metrics before migration begins and validate results against them after cutover — not just whether workloads moved.
What are the biggest risks in enterprise cloud migration?
The biggest risks include missed dependencies from incomplete assessment, security gaps from misunderstanding the shared responsibility model, cost overruns from cloud sprawl, application compatibility failures, and business continuity loss during cutover. A structured, wave-based migration with clearly defined rollback procedures addresses each of these directly.
